Techniques/Colour after sewing

COLOUR AFTER SEWING

Garment Dyeing

Colour is applied after the garment is sewn. The fabric, thread, rib, trims and construction must all be prepared for the same wet process.

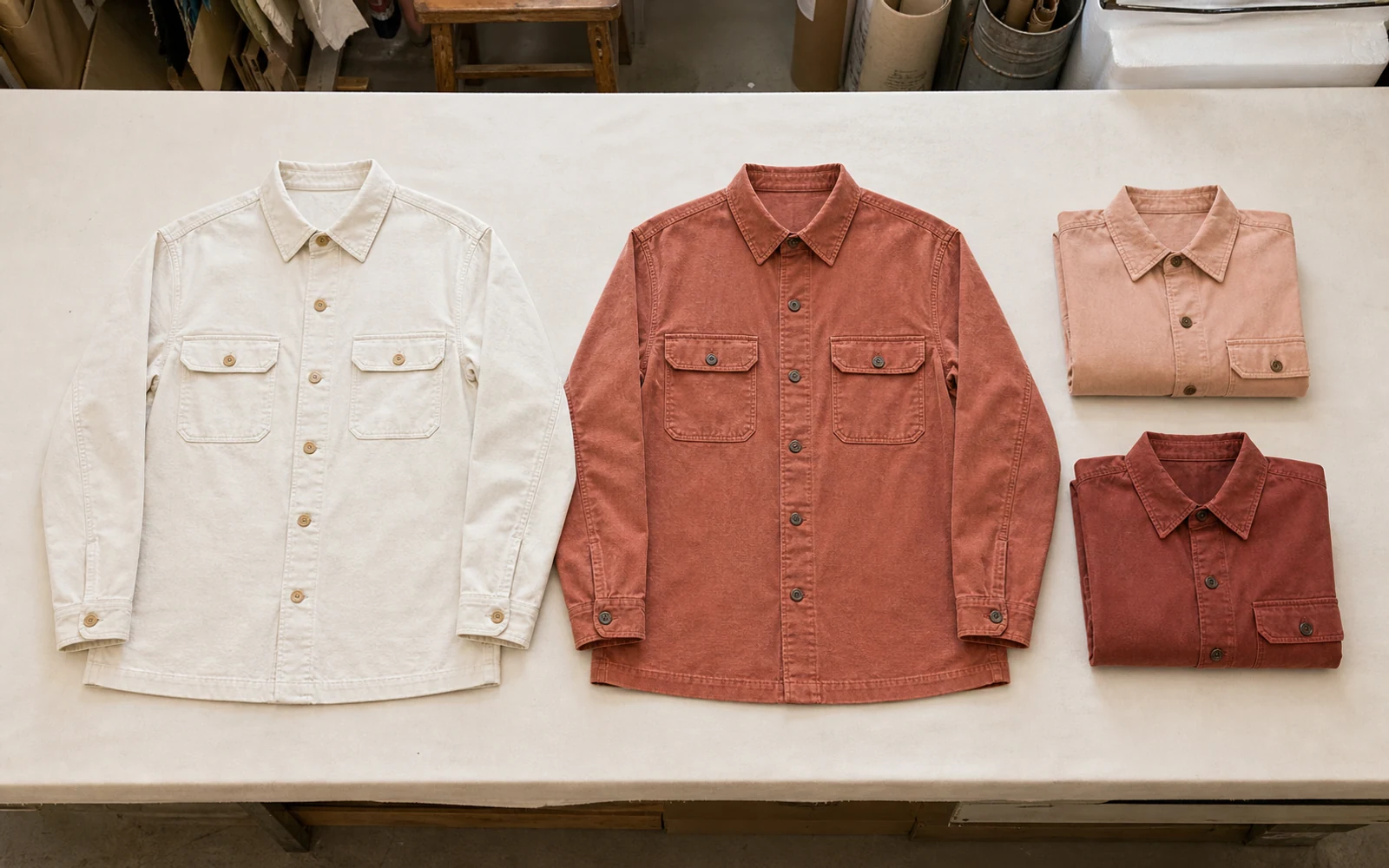

Undyed and garment-dyed versions of the same style
PFD garment, dyed target and approved shade range reviewed together
Garment
Complete style before the bath
Components
Thread, rib, zips, labels and trims
Release
Shade range plus finished measurements
01

PROJECT FIT

Is the complete garment ready for wet processing?

Start with the complete garment, not a colour name.

If one material, component or finished-size requirement is unknown, hold the route and test the actual style.

Four conditions that determine garment-dye suitability
01

Good candidate

Known fibre and preparation, dye-compatible components, an intentional casual or tonal result, and approval after processing.

02

Hold and test

Mixed fibres, unknown finishes, elastane, lining, interlining, zips, metal, elastic, decoration, heavy layers or fitted measurements.

03

Compare another route

Use another colour stage when the surface must remain pristine, colour must be approved before cutting, or shaped resist is the real target.

Best for

  • Dye-ready cotton or cellulosic casual garments whose complete component list can be checked before sewing.
  • Collections that benefit from deciding colour quantities after the undyed garments have been made.
  • Projects that can approve the processed garment, a physical shade range and finished measurements.

Hold when

  • A structured, padded, bonded or heavily interfaced garment has not passed a complete-style wet-process trial.
  • Mixed fibres, thread, rib, pocketing, zips, labels or trims must match exactly but their dye response is unknown.
  • The target requires a pristine untouched surface, zero shade tolerance or unchanged measurements.

Approve by

  • A complete component audit before sewing.
  • An actual-material, complete-garment process sample.
  • A physical colour standard with an agreed shade range and component contrast.
  • A finished-garment measurement and appearance record after the full dye, rinse, dry and finishing route.
02

COLOUR STAGE

Choose the colour stage before the process.

Garment dyeing applies colour after cut-and-sew.

Garment washing can change hand, shrinkage, abrasion or colour loss after the main fabric colour already exists.

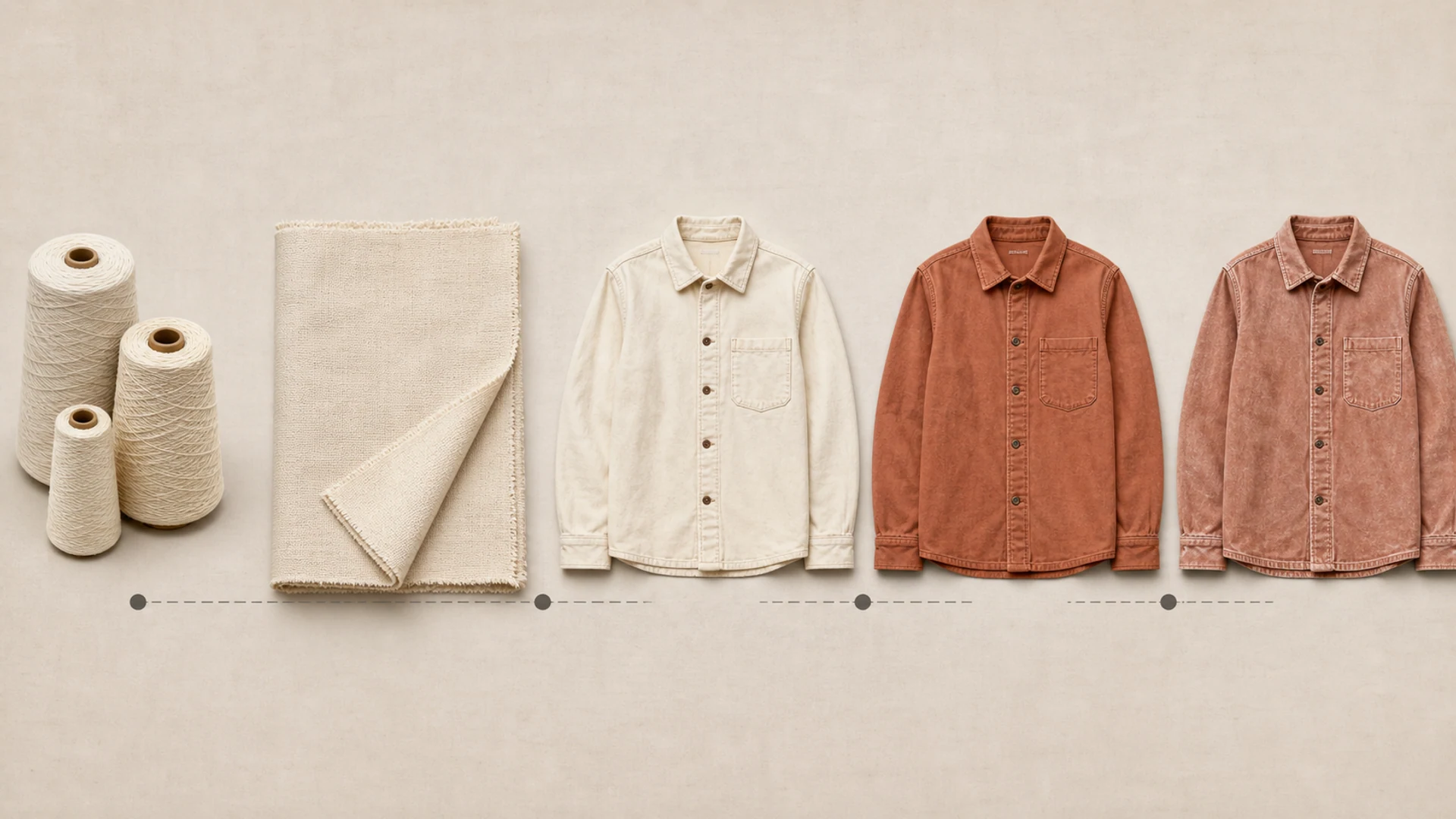

Where colour is applied in yarn, piece and garment routes
  1. 01

    Yarn dyed

    Approve yarn colour and the later knitted or woven pattern.

  2. 02

    Piece dyed

    Approve the fabric lot before thread and trims are added.

  3. 03

    Garment dyed

    Approve complete-garment colour, component interaction and finished measurements.

  4. 04

    Garment washed

    Approve hand, shrinkage, abrasion or intentional colour loss on an already coloured garment.

03

BATH-READY BUILD

Build every component for the bath.

The complete bill of materials enters wet processing together.

For each component, decide whether it should match, finish tonal, remain contrast or be added later.

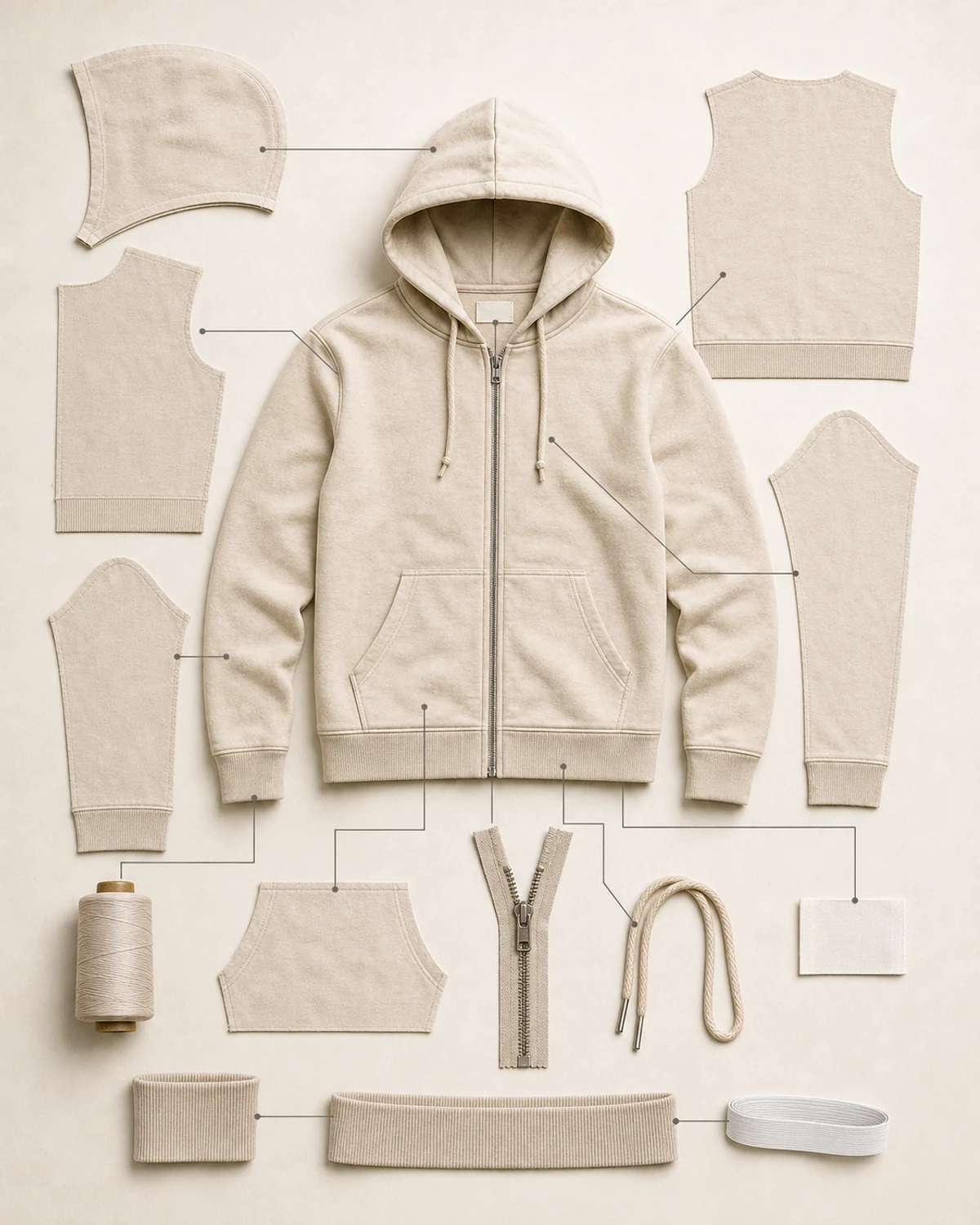

Complete garment component audit before dyeing
Thread and rib can dye differently from the shell
Trims that must be tested or added after dyeing
01

Shell

Confirm fibre, construction, weight, preparation, prior finish, shrinkage and torque.

02

Thread, rib and pocketing

Specify whether each part should match, finish tonal or remain deliberately contrasting.

03

Interlining and facing

Test matting, pilling, shrinkage, crumpling and complete-style shape after processing.

04

Zip, hardware and labels

Test the exact part for colour response, staining, reaction, legibility and the correct point of attachment.

05

Elastic, drawcord and decoration

Approve recovery, shrinkage, heat and chemical tolerance, colour intent and order of operations.

04

ROUTE SELECTOR

The garment stage is fixed. The dye route is not.

Identify the fibre, preparation and prior finish before discussing a route.

The dyehouse must confirm the actual chemistry, equipment and complete-garment limits for the project.

Cellulosic reactive route requires fixation and wash-off
Reactive and pigment garment colour are separate routes
01

Prepared cotton or cellulosic

Confirm the exact cotton or reactive route, physical shade, preparation, fixation, wash-off and tests.

02

Pigment-style surface

Approve weathered character, binder-related hand, shade range and dry and wet rubbing separately.

03

Blend or stretch

Approve intended tonal contrast, safe heat history, dimensional movement, stretch and recovery.

04

Polyester or polyester-rich

Confirm supplier capability, specialised equipment, the actual dye route, trims and complete-style tolerance.

05

Unknown material or finish

Identify and trial the material before quoting a route.

05

PROCESS PATH

From PFD garment to released bulk.

A useful process path starts before sewing and ends after shade sorting and finished measurement.

No one temperature, recipe, liquor ratio or shrinkage value applies to every material and style.

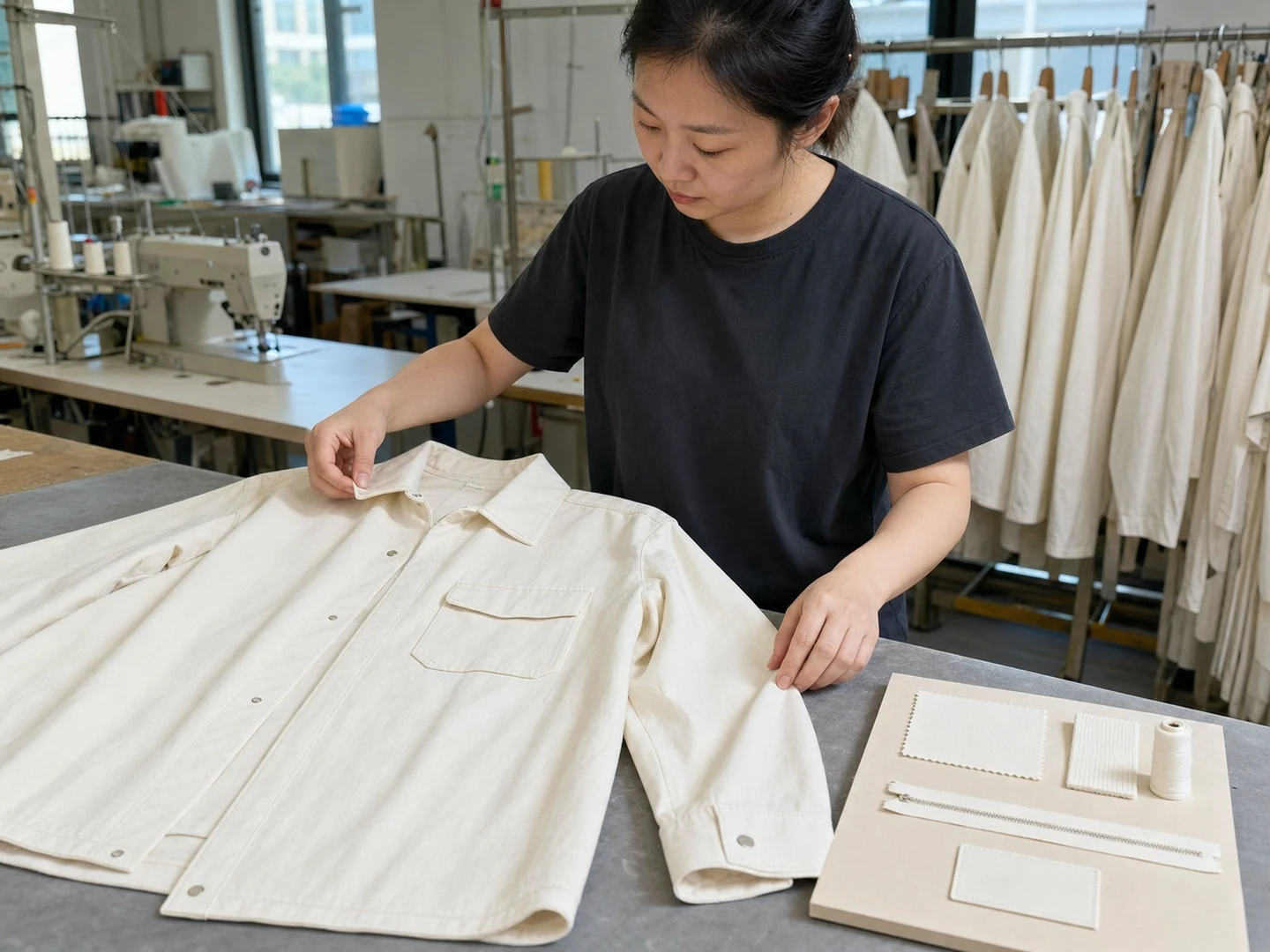

Checking the PFD garment before wet processing

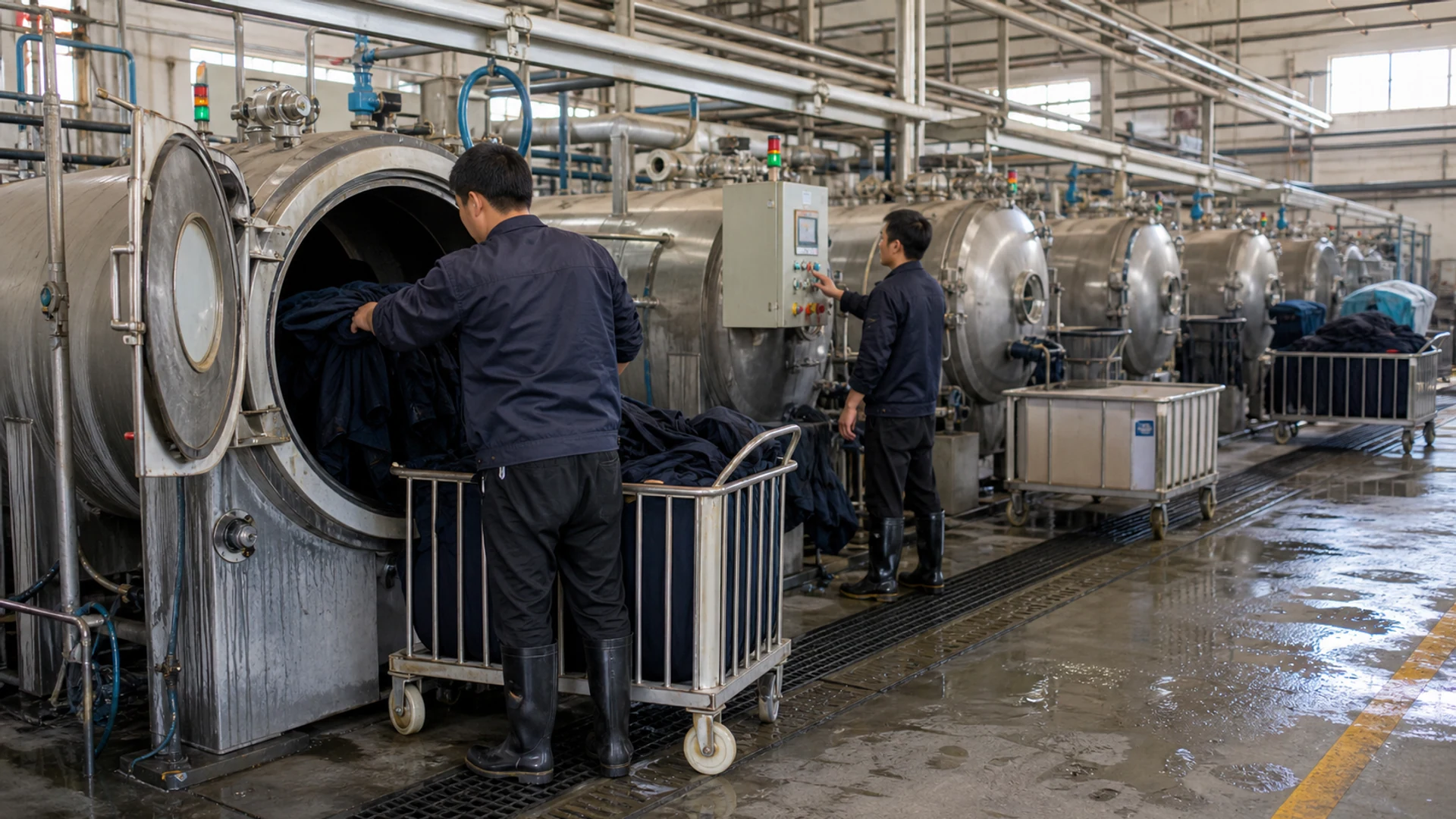

Garments moving through a controlled wet process

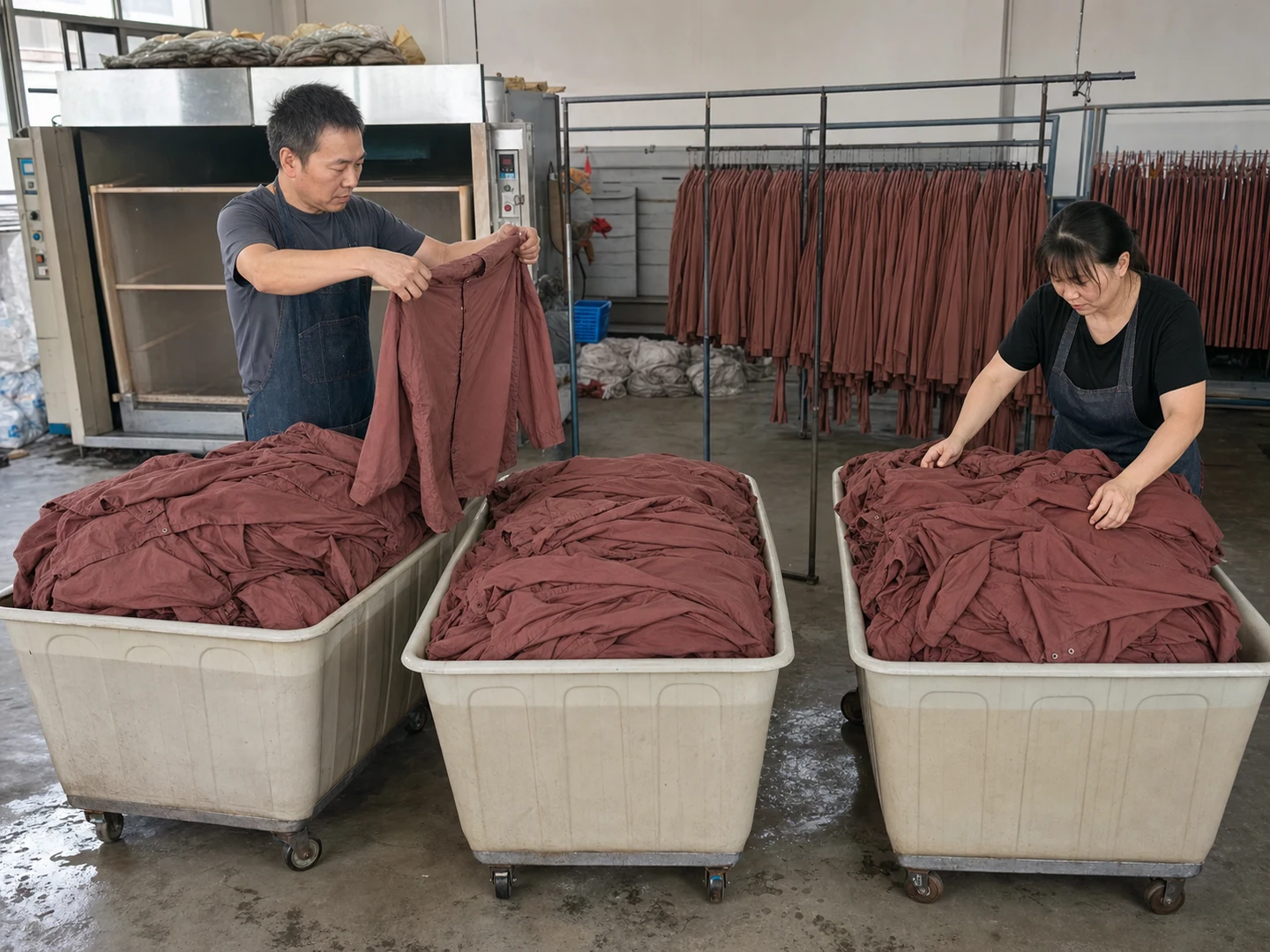

Handling garments after rinsing, extraction and drying
  1. 01

    Define the target

    Lock style, quantity by colour, physical reference, intended surface, care and tests.

  2. 02

    Engineer the PFD garment

    Lock preparation, component intent, seam settings and pre-process measurements.

  3. 03

    Run the garment trial

    Use actual material and complete components through a recorded sample route.

  4. 04

    Dye, rinse and neutralise

    Use the controlled route selected for the actual fibre, shade, garment and equipment.

  5. 05

    Extract, dry and finish

    Use the approved dry route and recheck hand, surface and dimensions.

  6. 06

    Sort, measure and release

    Check shade, component match, measurements, torque, seams, hardware, labels and agreed tests.

06

TRADE-OFFS

Why use it — and what it changes.

Later colour allocation can be commercially useful, but it does not remove material, style or machine constraints.

Every finished garment already contains sewing value before it enters wet processing.

01

Decide colour quantities later

The actual minimum still depends on style, material and machine or load feasibility.

02

Split a prepared base into colour lots

Wet-process rejection happens after cutting, sewing and component value have been added.

03

Create tonal component effects

The same fibre differences can also create an unintended mismatch.

04

Achieve a relaxed colour character

That surface may be wrong for a pristine, crisp or structured target.

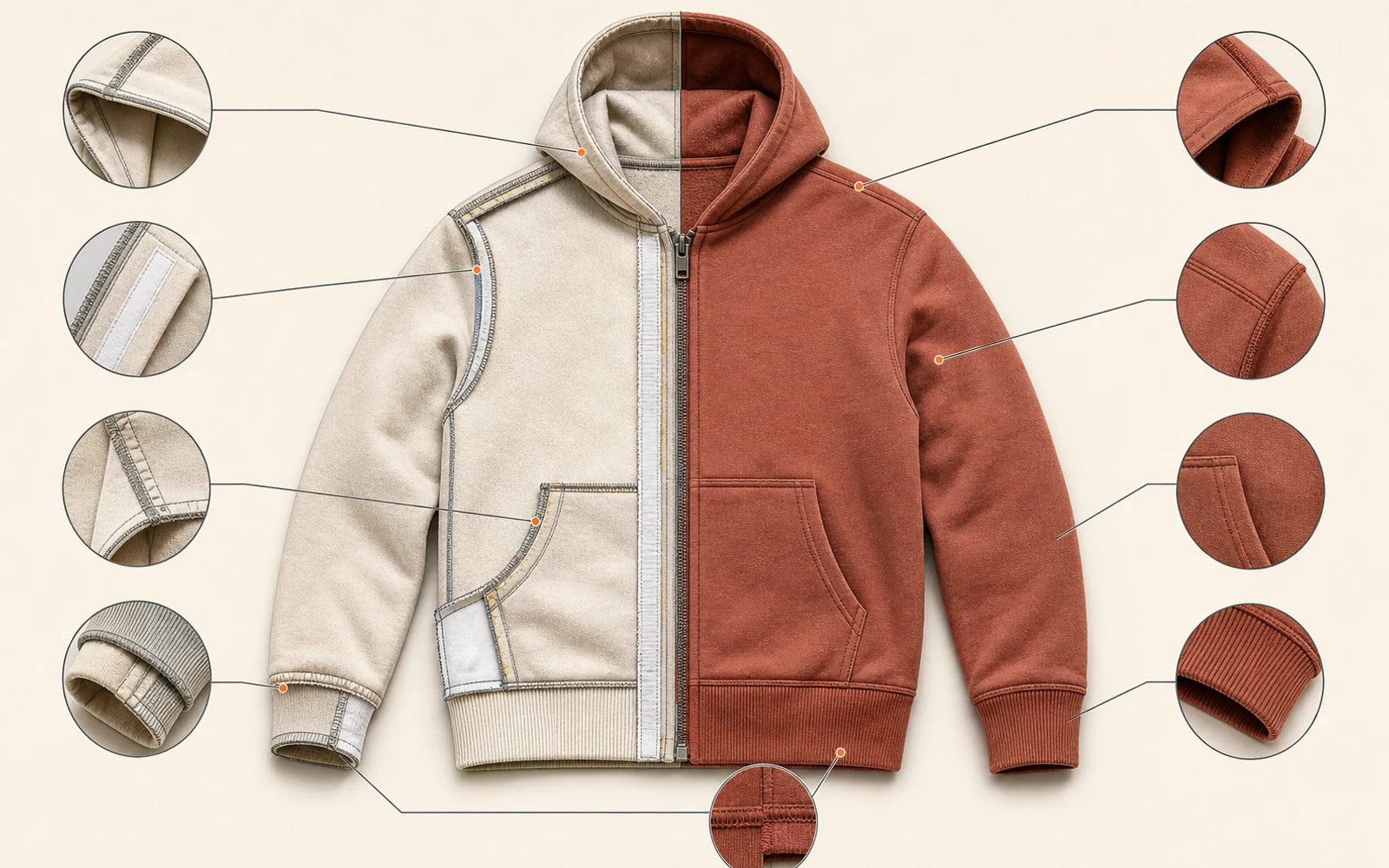

Construction areas that can change the garment-dyed result
07

CONSTRUCTION MAP

The colour follows the construction.

The dye bath reaches a complete three-dimensional garment, not a flat colour swatch.

Approve construction high and low, tonal contrast and unacceptable defects on the actual processed style.

01

Side seam

Check pucker, torque, straightness and thread appearance after full drying.

02

Pocket and double layer

Separate acceptable construction high and low from accidental resist patches.

03

Rib and binding

Approve a match, tonal range or deliberate contrast.

04

Waistband and interlining

Check internal shrinkage, crumpling, matting, shape and final measurement.

05

Zip and hardware

Check the exact component for tape mismatch, staining and finish change.

08

DUAL APPROVAL

Approve colour and finished size separately.

A lab shade is a colour direction, not proof of complete-garment behaviour.

Use a production-representative first-off to compare colour, component response and finished measurements before bulk release.

Physical garment shade range for bulk approval
01

Colour record

Record the physical target, viewing light, accepted light-to-dark range, component contrast, construction boundary and shade-sort rule.

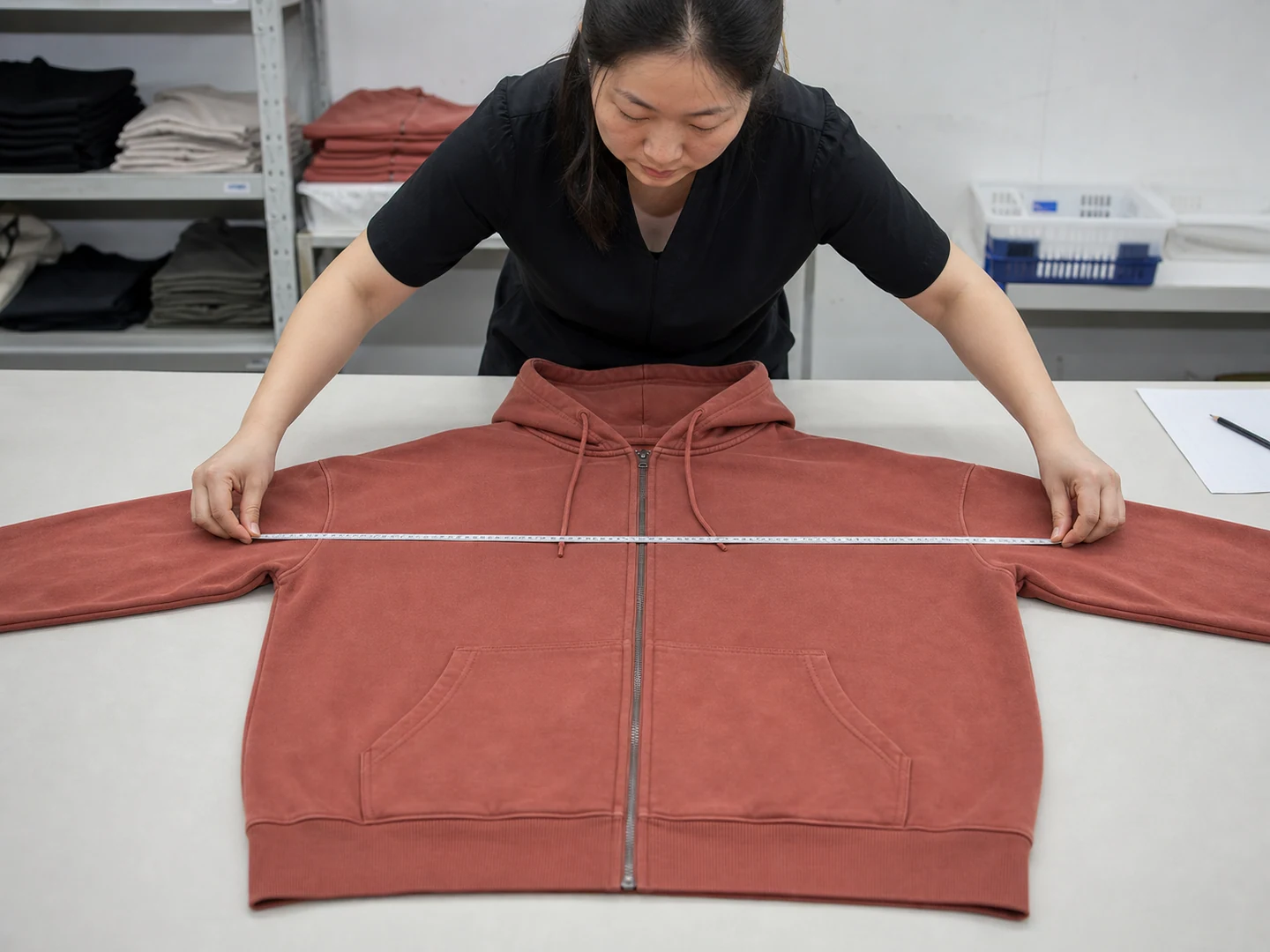

Measuring finished dimensions after garment dyeing
02

Finished-garment record

Record key measurements, torque, seam appearance, stretch or recovery, hardware, labels, hand, care and agreed tests.

09

STYLE COMPATIBILITY

Start with the garment structure.

A silhouette does not prove dye readiness.

Compatibility depends on the material, colour, stretch, structure, quantity, wet-process tolerance and the approved garment sample.

Garment structures require different dye-readiness checks
01

T-Shirts and hoodies

Check prepared jersey or fleece, torque, neck or waist rib, heavy layers, drawcord, drying and finished size.

02

Shirts and bottoms

Check seam pucker, collar or waistband structure, pocketing, elastic, drawcord and finished measurements.

03

Dresses and jackets

Check drape, length, lining, interlining, zips, hardware, thick seams and abrasion.

04

Blazers and coats

Treat tailoring, fusing, lining, padding, hardware, pressing and shape as a high-complexity complete-style trial.

05

Abaya

Confirm the actual fibre, drape, length, embellishment, embroidery, trim and colourfastness rather than inferring suitability from the silhouette.

10

SAMPLE TO BULK

The complete garment is the real sample.

A flat lab trial cannot show every seam, trim, layer and finished measurement.

Use the actual-material complete garment and a production-correlated route for the release decision.

  1. 01

    Material and component audit

    Record every shell, sewing, internal, trim and decoration component.

  2. 02

    Colour-route trial

    Set shade direction and route family without treating a flat trial as complete-garment proof.

  3. 03

    Complete-garment sample

    Process the actual construction and components through the intended wet and dry sequence.

  4. 04

    Shade-and-size approval

    Sign the physical shade, component contrast, finished measurements, seam, hand and care.

  5. 05

    Production first-off

    Compare the production-representative load and record with the signed approval.

  6. 06

    Bulk record

    Retain shade grouping, measurements, defects, agreed test results and the approved reference.

11

DIAGNOSTIC BOARD

If the result moves, identify what moved.

Judge each defect against the signed shade, component and finished-garment records.

Do not use one generic pass grade for every colour, material, care route or destination market.

Unintended unlevel shade after garment dyeing
01

Unlevel shade

Review preparation, wet-out, water, load, movement, additions, machine cleanliness and shade sorting.

Seam pucker and dimensional movement after wet processing
02

Seam pucker or size drift

Review residual shrinkage, thread and fabric interaction, dry route, stretch history and post-process measurements.

Component mismatch and staining on a garment-dyed style
03

Component mismatch or staining

Review exact fibre, finish, component chemistry, attachment sequence and the processed component sample.

04

Fastness and pH

Agree the applicable rubbing, wash, staining and pH methods, care conditions and limits before testing.

14

BUYER FAQ

Questions before you garment-dye a style

Approve the complete processed garment, not a process name or a screen colour.

Every route remains conditional on the actual material, components, shade, equipment and sample.

01Is garment dyeing the same as garment washing?+

No. Garment dyeing applies the garment's colour after sewing. A garment wash may soften, pre-shrink, abrade or remove colour that already exists.

02Can every garment be garment dyed?+

No. Fibre, finish, construction, thread, rib, trims, elastic, hardware and the required process must all be compatible.

03Will thread and rib match?+

Only if their fibre and treatment are selected for that result. Approve the actual seam and rib on the complete garment.

04Can you match a Pantone colour?+

Use a physical reference to set the target and approve the processed garment against an agreed shade tolerance.

05Will the finished size change?+

It can. Approve length, width, torque, stretch and seam appearance after the full wet and dry process.

06Does garment dyeing reduce the MOQ?+

It can delay colour allocation, but material, style and machine limits remain. The usual MOQ is 100 pieces per style per colour, subject to material or specific-style variation.

07Is garment dyeing more sustainable?+

Not automatically. The actual machine, water, energy, chemistry, rework, wastewater and facility controls determine the impact.

08What must be approved before bulk?+

Approve the actual-material complete garment, physical shade range, component colour, finished measurements, seam, surface, hand, care route and agreed tests.
